Posted

Please help, I have 4 field date and time from and date and time to

This the sample format 4pm 07/07/05  and  8pm 07/08/15

Posted

Assuming you want to calculate the elapsed time, make the calculation =

Timestamp ( DateTo ; TimeTo ) - Timestamp ( DateFrom ; TimeFrom )

and set the result type to Time.

  • 7 months later...
Posted (edited)

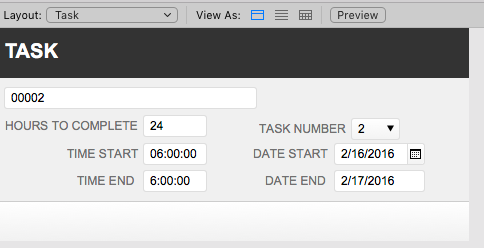

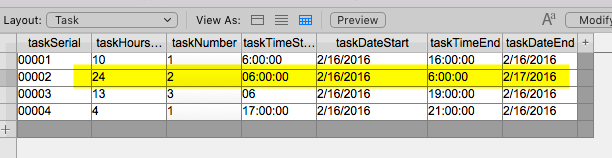

I have a previous post here about this but i deleted it because of confusion. The calculation @comment provide me is working but i have a problem, I am not sure if its on relationship or calculation field of the date and time. I attach the example data. In task layout record 2 as you see the hours to complete is 24 so when i start at 6:AM of feb 16 it suppose to end at 6:AM feb 17. In View layout it should show but it is not appearing when i select the date of Feb 16. I also notice when i add record that exceeds at 12:AM it is not showing.

Task Scheduling.fmp12

Edited by chadski021
change table to layout
Posted

Ok, let's make sure you have the lingo right.  When you mentioned "view table" I assumed  you meant "table view".  So be clear to let us know what layout you are seeing or not seeing something.

Posted

it's because your time end (even though on a different date) is not greater than 6am, so the relationship from the 7am and later timeslots is not valid.

You'd be better off using a timestamp field for the relationship instead of separate date and time fields.  The end-time field does not know it belongs to the next day...

Posted

you wouldn't need a relationship on the date or time fields, just one on a new timestamp field in the Time table (that is a combination of the global date and the time field)

and you'll need new timestamps field in Tasks, one for start and one for end and base the relationship on these.

Posted (edited)

Thank you it seems to be working fine. By the way how do i calculate the endtimestamp? Right now i am using 3 fields Hours to Complete, Start Timestamp and End Timestamp. I know @comment provided me a calculation for this but i deleted the thread.

Edited by chadski021
Posted

Don't delete threads, even if they are confusing.  There's always something to be learned from it.

You calculate the ending timestamp just like you do for the starting timestamp:

Timestamp ( taskDateEnd ; taskTimeEnd )
